15th of May Bridge - Egypt
Bridges & Flyovers Completed

15th of May Bridge - Egypt

Country
Egypt
City
Cairo
Start Date
2000
Project Status
Completed

About the Project

Owner: Cairo Governorate - Roads and Bridges Authority
Executing Agency: Arab Contractors Company "Osman Ahmed Osman & Partners" - Bridges Department
Consultants: Arab Consulting Engineers "Dr. Moharam - Dr. Bakhoum" Misr Dividage Company
Delivery Date: April 20, 1986

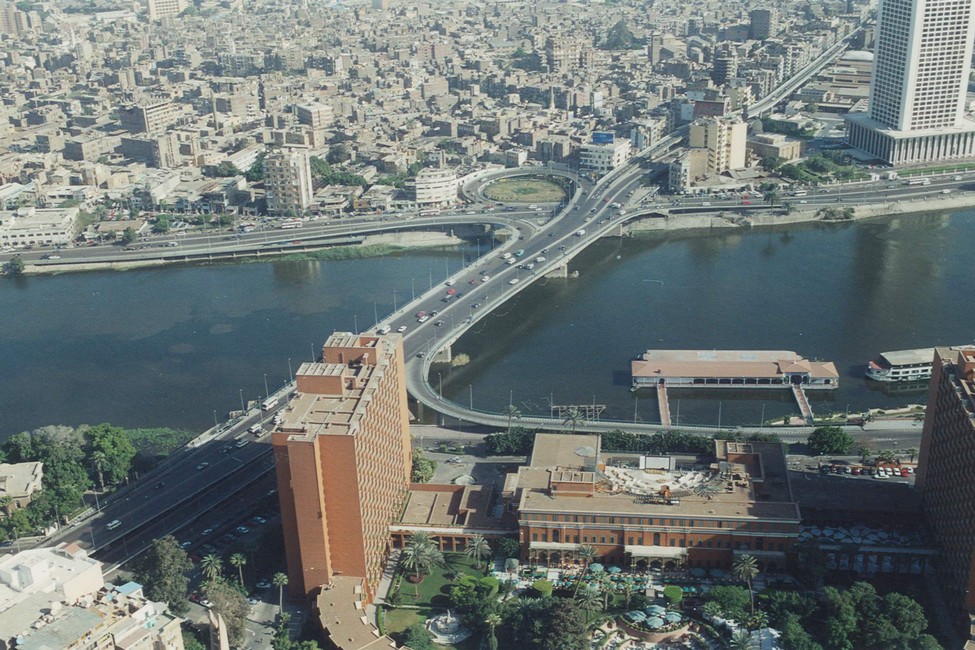

Project Description: The bridge passes over 26th of July Street in Zamalek and connects Abu El-Ela Bridge to Zamalek Bridge
Length: 1,000 meters
Width: 16.60 meters
Number of Columns: 39 columns, 25 meters apart
Foundations: (200) hollow piles
Construction Method: The superstructure is made of prestressed concrete, with two types of cables used.
The first type: Dywidag cables, 36 mm diameter, 835/1030 steel, with single bar tendons in the upper and lower slabs.
Type 2: Multiple Strand Tendons Cables. Each cable consists of 12 strands, 0.6 inches in diameter, made of 1570/1770 steel, with a longitudinal beam.
The superstructure was constructed using a deck-pushing system, the first in Egypt, to avoid obstructing traffic on 26th of July Street in Zamalek.

Key Features

Distinctive Architectural Design
Modern design meeting the highest standards
Professional Project Management
Integrated coordination among all stakeholders
High Safety Standards
Full commitment to safety regulations
Exceptional Quality
Execution with the highest quality standards
Client
Cairo Governorate
Start Date
2000/01/01
Space
الطول : 1000 متر - العرض : 16.60 متر
